St John's Wood Square

St. John’s Wood Square

Cambell Brown Engineers delivered a comprehensive temporary works and construction methodology for one of London’s most complex basement projects, enabling safe delivery and supporting a landmark residential development.

St. John’s Wood Square (StJWS) is a landmark residential development in the City of Westminster, London NW8. The project comprises nine residential buildings with up to three basement levels across an extensive footprint. The site is surrounded by sensitive infrastructure, including Jubilee Line tunnels and Thames Water sewers, requiring a highly coordinated approach to design and construction.

Our objective was to develop a robust construction methodology for the substructure, addressing complex engineering challenges early to streamline contract negotiations and ensure safe, efficient delivery.

Project Challenges

Cambell Brown Engineers worked closely with Careys and the project design team to understand the brief and distill the key constraints.

Overconsolidated Clay

The soil exerts high lateral pressures onto the basement walls as the clay is geomorphically younger and less consolidated than found elsewhere in central London. (Most Clay in London has a K0 = 1.0) High lateral pressures require larger props, which induce greater thermal loads, cyclically requiring larger props.

Sensitive Neighbouring Assets

Sensitive third party assets (Jubilee Line and Kings Sewer)are below and within close proximity of the site. These invoked strict movement criteria by TfL and Thames Water

Acoustic Isolation Requirements

The entire basement is to be acoustically isolated. This presents unique challenges as the Natural rubber isolators have anisotropic properties, where they provide only compression resistance with no shear or tension.

Large-Scale Excavation Geometry

Large scale excavation cause significant global movements as the soil trys to equalise. This results in buoyant uplift on the basement and settlement of the neighbouring area. combining this challenge with the overconsolidated clay results in a complex ground movement profile that must be managed carefully.

Structural & Architecural Geometry

The ground floor slab has too many voids, steps and folds to transfer the lateral earth pressure across the site; only the lower ground floor can provide complete diaphragm action.

Programme Interfaces

Other programme constraints that needed to be considered included:

  • Westminster City Council limited vehicle movements to 110 per day.
  • Party Wall Awards required the south-west boundary wall to be completed within 18 months.
  • Early Handover of Riding School and Marketing Suite to be delivered early.

Designed Sequence & Methodology

We implemented a five-step construction methodology combining top-down construction with traditional excavation and strategic propping.

Step 1 Initial Excavation

Step 1 – Initial Excavation: beneath the Garden Square’s top-down slab to formation level (+43.940), releasing earth pressures from the north and west.

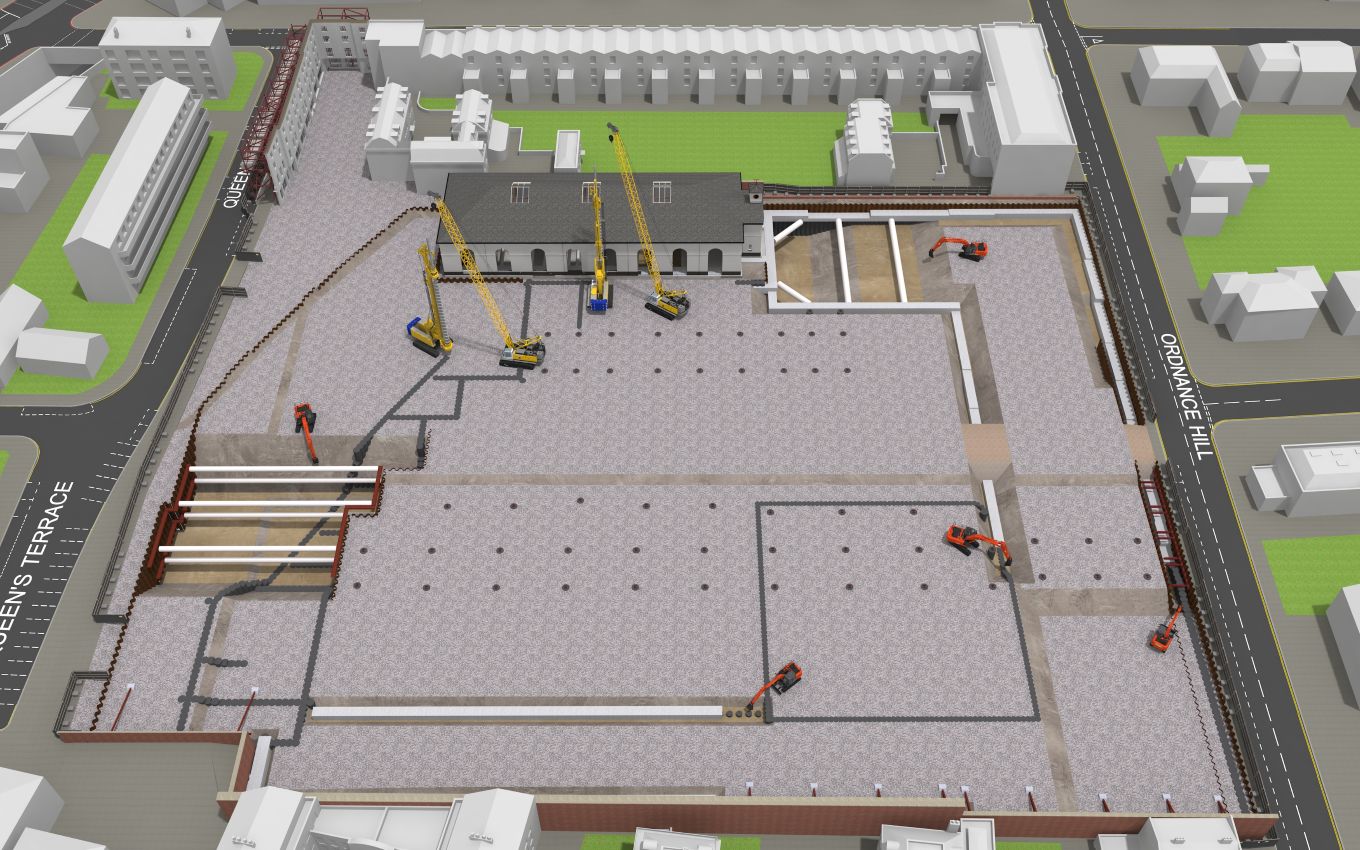

Step 2 Extended Excavation
Step 2 – Extended Excavation: progress to full formation level, stabilizing Blocks 5 and Drop-off Square and relieving eastern boundary pressures.

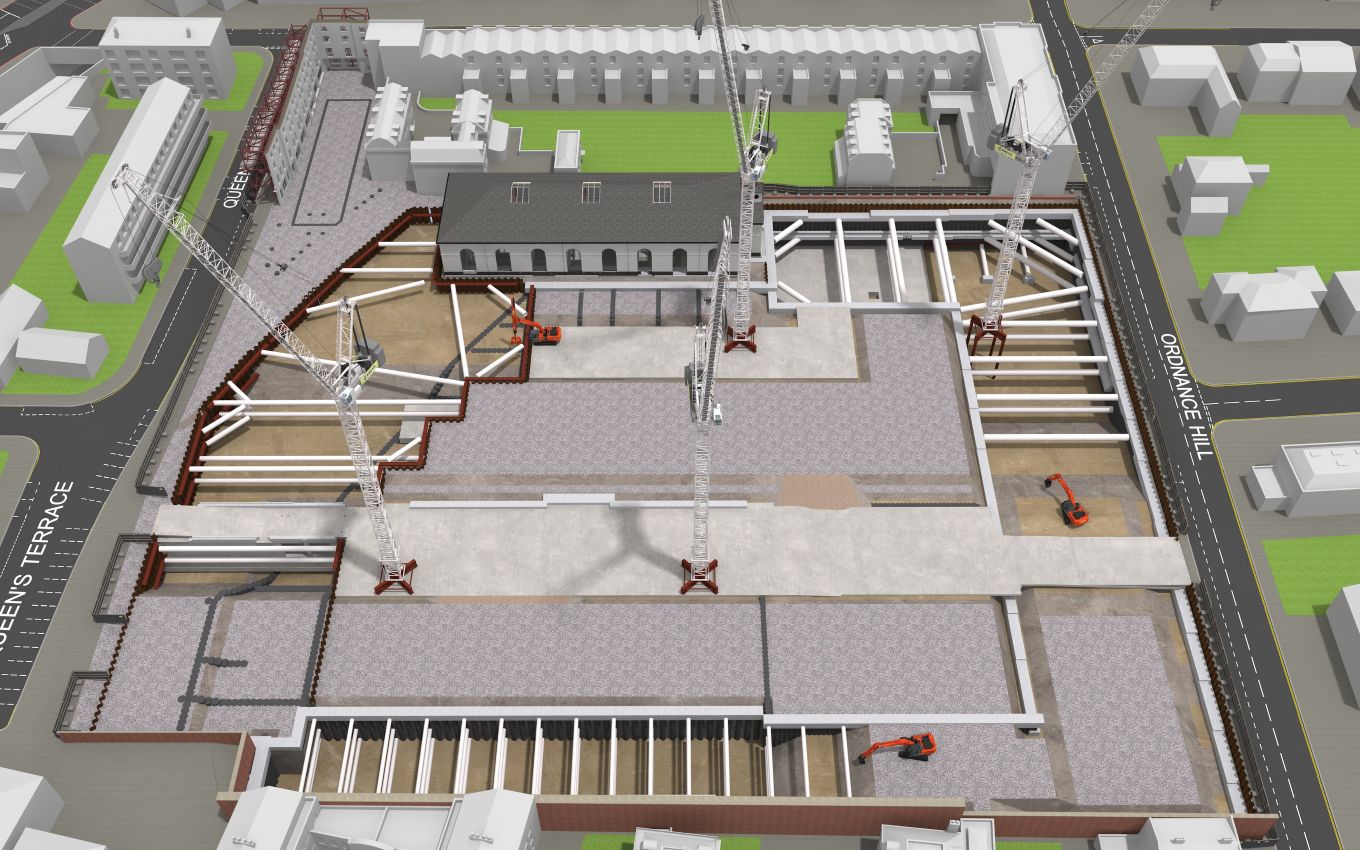

Step 3 Temporary Works Integration
Step 3 – Temporary Works Integration: transfer earth pressures through top-down structure into permanent load path, mitigating locked-in stresses.
Step 4 Permanent Structure Transition

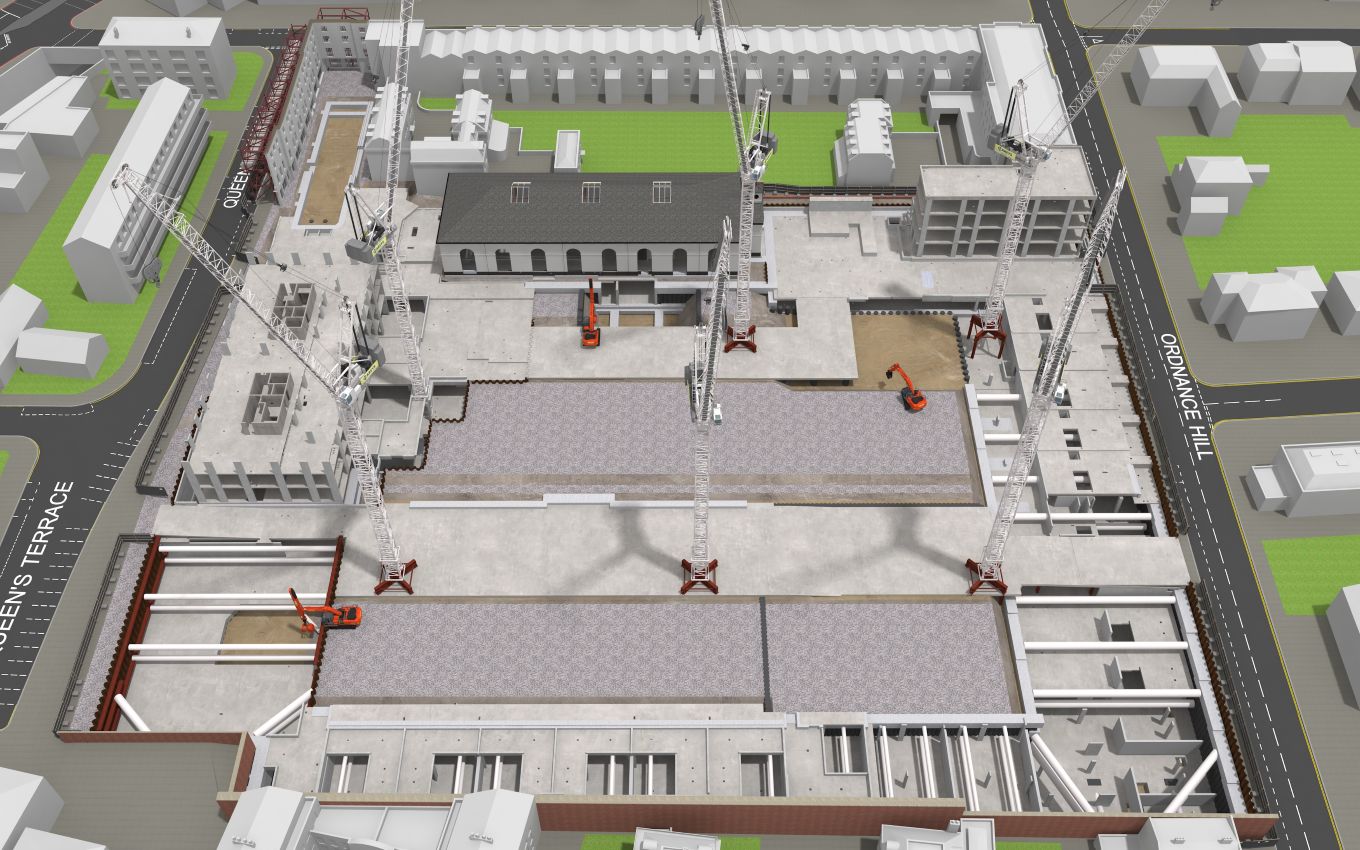

Step 4 – Permanent Structure Transition: build permanent elements before opening Block 4 and southern boundary to maintain north–south pressure balance.

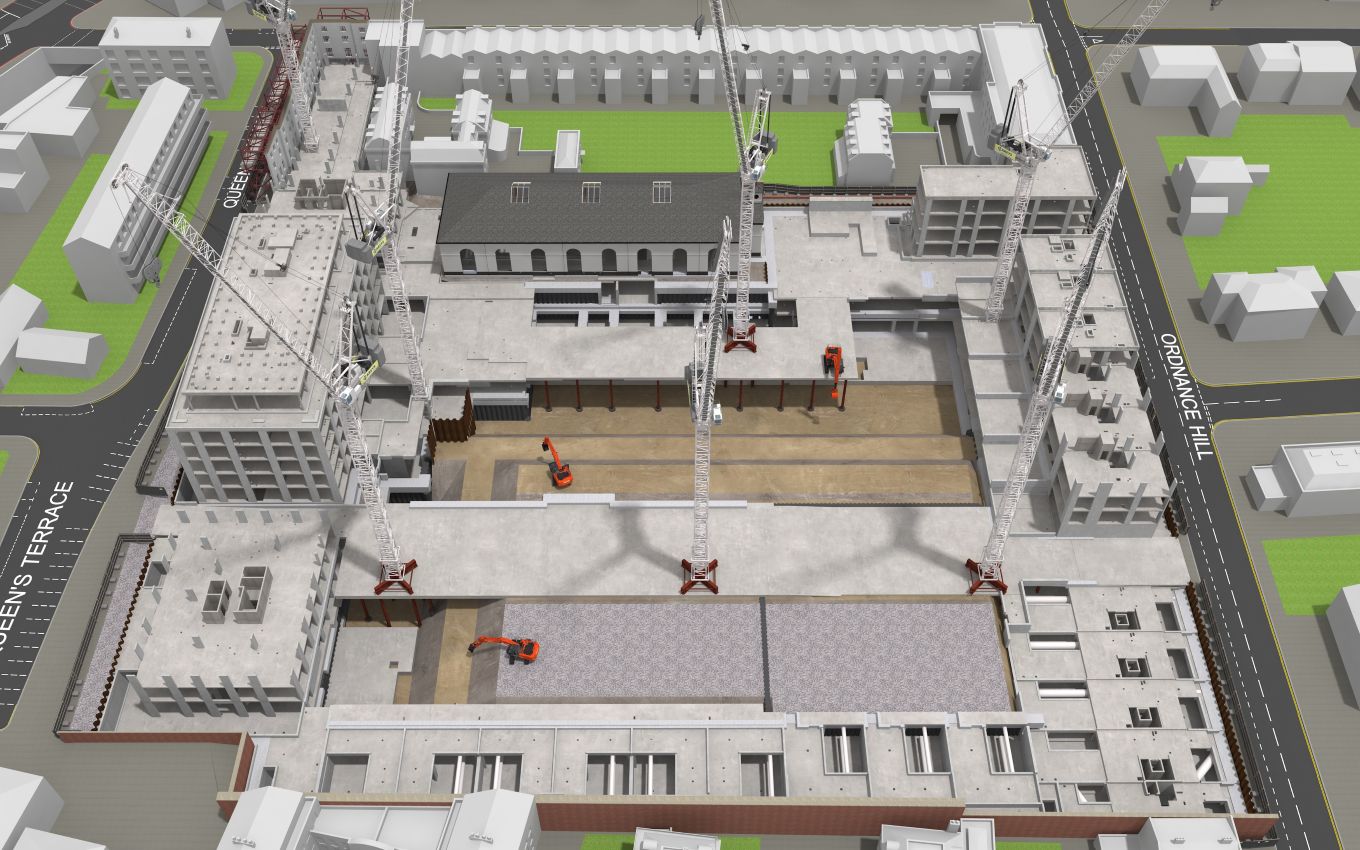

Step 5 Sensitive Asset Protection
Step 5 – Sensitive Asset Protection: sequence works near Jubilee Line tunnels and King’s Sewer last to minimize exposure and buoyancy risks.

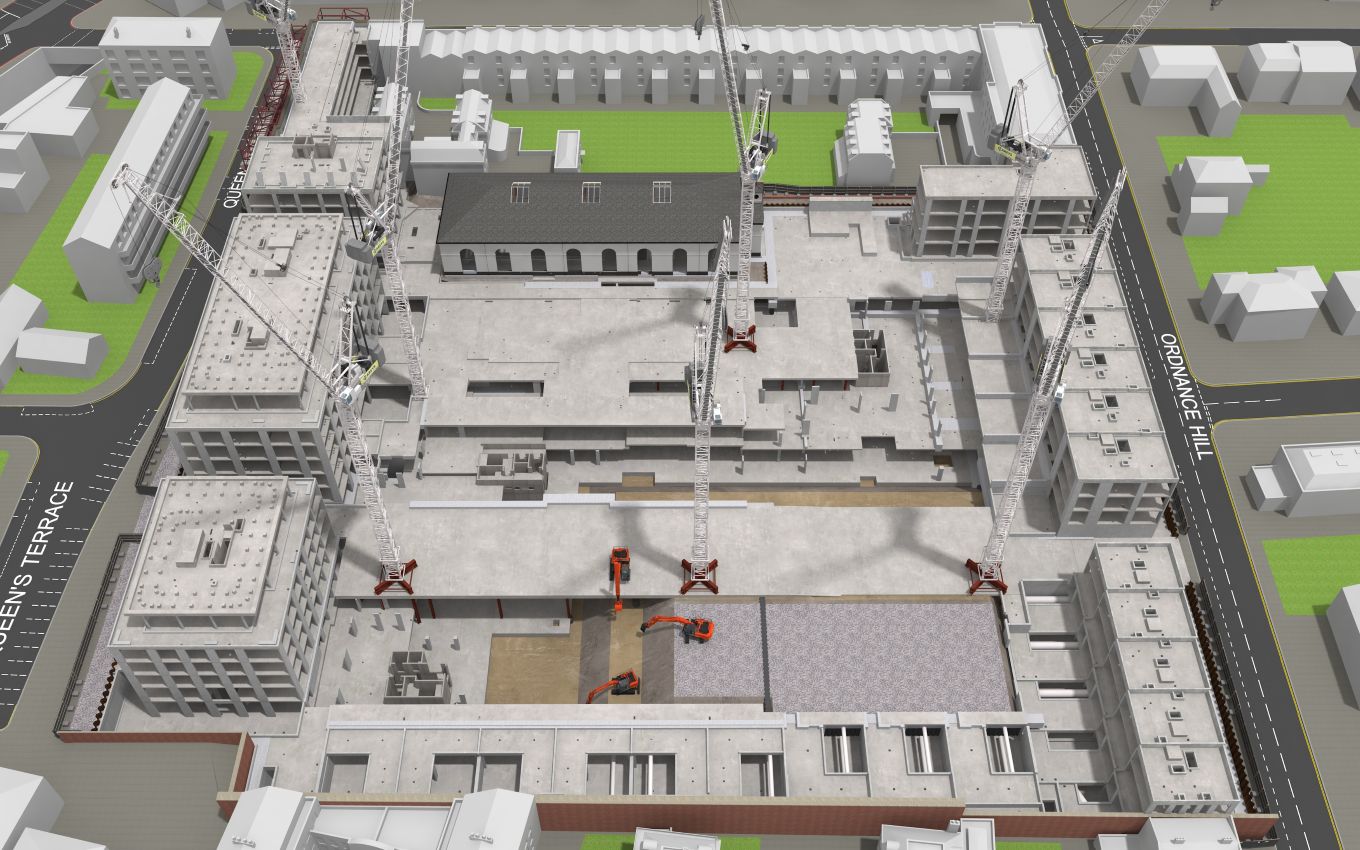

Step 6 Final Stage
Step 6 – Final Stage: complete the final stage of construction, ensuring all elements are fully integrated and operational.

This approach was supported by ground movement analysis from Robert Bird Group (RGB) and Geotechnical Consulting Group (GCG), ensuring compliance with strict design limits.

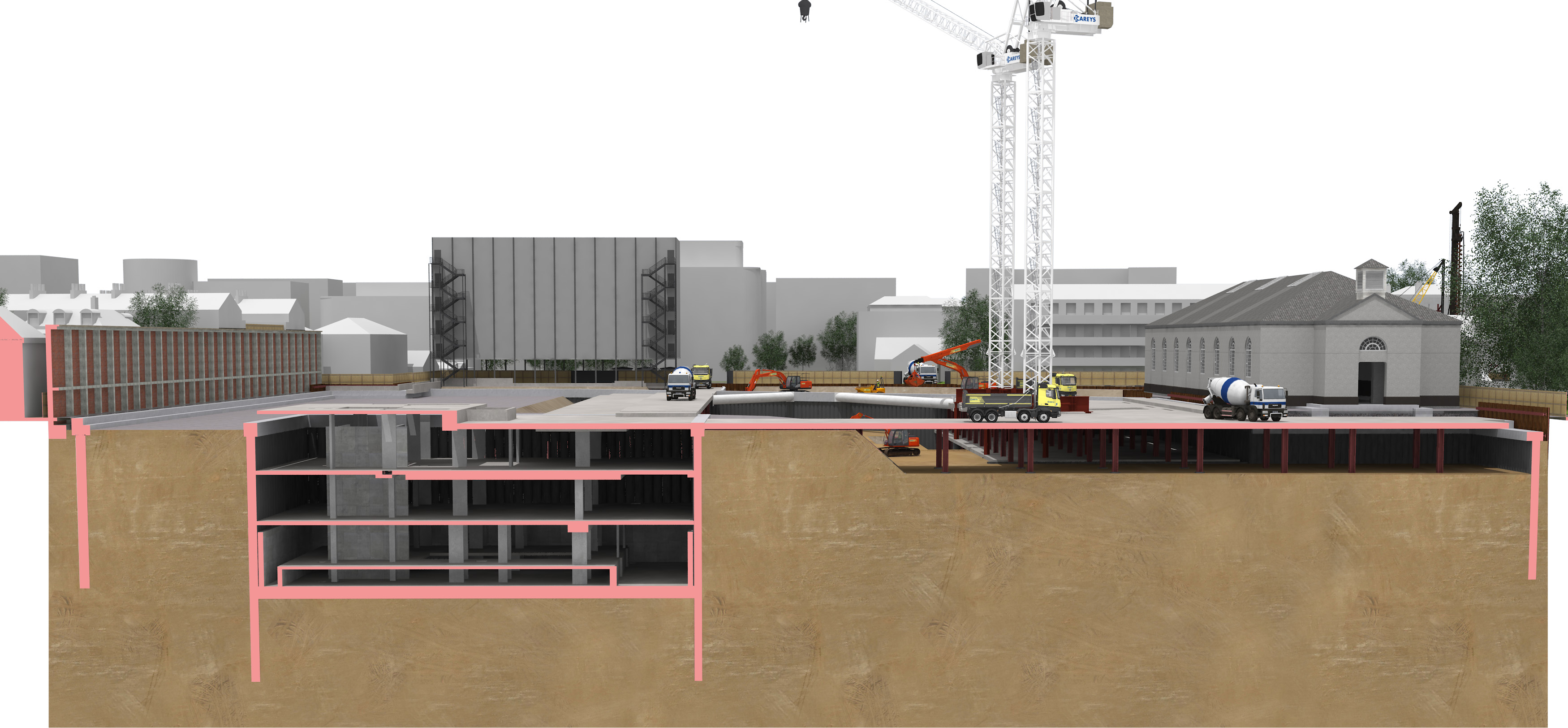

Putting the Sequence into Action — Temporary Works Design

To deliver the sequence of works, temporary works were designed as a holistic system. The key features included:

We designed a robust façade retention system to support the retained façade along Queen’s Terrace, preserving architectural heritage while enabling excavation works.

We coordinated diversions and designed the substation base in accordance with UKPN requirements to maintain essential services and avoid programme delays.

We developed traffic management solutions to comply with movement limits, including swept path studies and defining road and street furniture alterations.

We designed layouts to optimize space and ensure safety, including an accommodation gantry coordinated with Traffic Engineering requirements. Hoarding was set at 3.6 m and included a living wall to harmonize with the surroundings.

Along the south boundary, a 9 m masonry wall required temporary support. CBE undertook the design and provided calculations to discharge Party Wall Awards.

We designed piling mats to provide safe working platforms for heavy plant and piling rigs.

CBE engineered the basement propping system to resist high lateral earth pressures and maintain structural stability during excavation.

We designed top-down slabs to integrate with the excavation sequence, providing diaphragm action and supporting temporary works.

The acoustic bearings were a contractor-designed item requiring temporary support. We coordinated design interfaces to ensure compliance and safety.

Working with our client Careys and the crane supplier, we developed a crane strategy for all phases of delivery. We designed crane grillages and bases to accommodate tower cranes within constrained site conditions.

Preliminary pile designs were developed to coordinate with temporary works solutions and provide robust specifications for tendering.

CBE prepared drawings and calculations for all temporary works items to discharge Party Wall Award requirements.
